Need help?

MBA641 Strategic Project Management Report 3 Sample

MBA641 Strategic Project Management. Ass 3

Your Task

Individually, you are required to complete comprehensive risk analysis and stakeholder management plan based on your work in the first and second assessments. Therefore, this assessment is a culmination piece.

Assessment Description

The purpose of this assessment is to foster students’ ability to evaluate and determine project viability, including the analysis required in the selection process. This will also form a part of students’ ability to create project portfolios that meet an organisation’s strategic goals and requirements and analyse project lifecycles and the processes involved in project development. Students will also demonstrate the criteria required to evaluate the success of projects based on an organisation’s goals, strategy and standards and analyse the project lifecycle and the process involved in project development.

Assessment Instructions

Presume that you are advancing for the STH BNK by Beulah project and that you have now been asked to prepare a detailed risk analysis and stakeholder management plan before commencing the project. Complete a comprehensive risk assessment of your project proposal and statement of work (SOW), linked directly to the case study. In addition, complete a stakeholder management plan, in which you will propose ways to manage the relationships between the stakeholder groups identified the case study and the proposals you have put forward in the first and second assessments. Your analysis needs to bedirectly linked to the case study and related to all the elements you addressed in the Project Strategy Framework and Statement of Work (SOW). Your risk analysis should be approximately 800 words. In it, you must include the concepts studied in weeks 4 and 5, accompanied by at least one or more of the risk assessment techniques used, such as risk assessment grid or project risk picture. You must identify potential risks in addition to your research on the project and its site by stating a clear outline of how these will be managed.

Your stakeholder management plan should be approximately 1200 words. In it, you must follow an appropriate, professional presentation style addressing the client who has commissioned the project and should include the identification of the various stakeholders, their interest and influence over the project, and a clear outline of the engagement strategy for each stakeholder group. Please don’t forget to outline the appropriate objectives and measures for the various stakeholders, using the relevant frameworks, concepts and diagrammatic tables, as necessary, to explain your reasoning clearly and concisely.

In addition to the case study, you are required to use at least 15 sources of information and use the Kaplan Harvard Referencing Style. These may include government publications, industry reports, and journal articles. These sources must be presented in the form of in-text citations and a reference list at the end of your submission. Wikipedia and other ‘popular’ sites are not to be used.

Solution

Introduction

This project will aim to discuss the risk management and stakeholder plan. Beulah's Sth Bnk Project is a construction project in Melbourne that aims to build the tallest and most eco-friendly building. According to the MBA Assignment Experts overview, This project will build two skyscrapers that combine luxury and sustainable patterns. One of the buildings will be 102 storeys while the other will be 59 floors. The construction project will involve many stakeholder groups along with risk assessments.

Risk Management and Control

Construction projects involve huge risks, investments and efforts; hence, risks can be considered a vital part of any construction project like that of Beulah’s Sth Bank Project. The project is exposed to many risks, including safety, financial, legal, project and environmental (Dekkers et al. 2016). Before continuing the explanation for risk management and control for Beulah’s Sth Bank Project. It is important to understand profound differences in uncertainty and risks. Uncertainty refers to events that are not known, while risks are generally calculated and known (Aven 2016). Although, uncertainty in each phase of the construction project might impact the success of Beulah’s Sth Bank Project. Thus, it is important to assess risks at every phase to explore unknown risks that might result in cost overrun, design failures and others.

Below is a risk description and analysis matrix, which will identify specific risks related to two construction phases.  

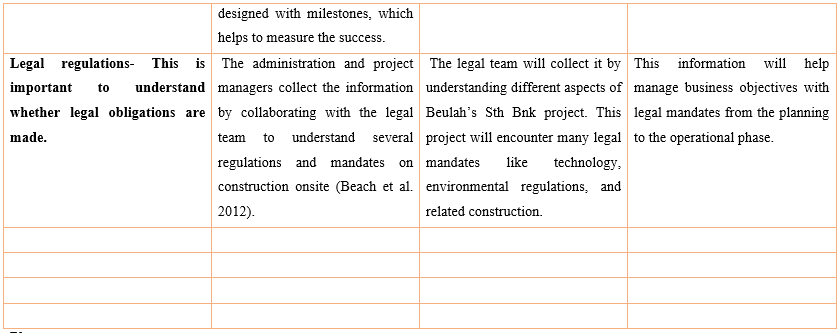

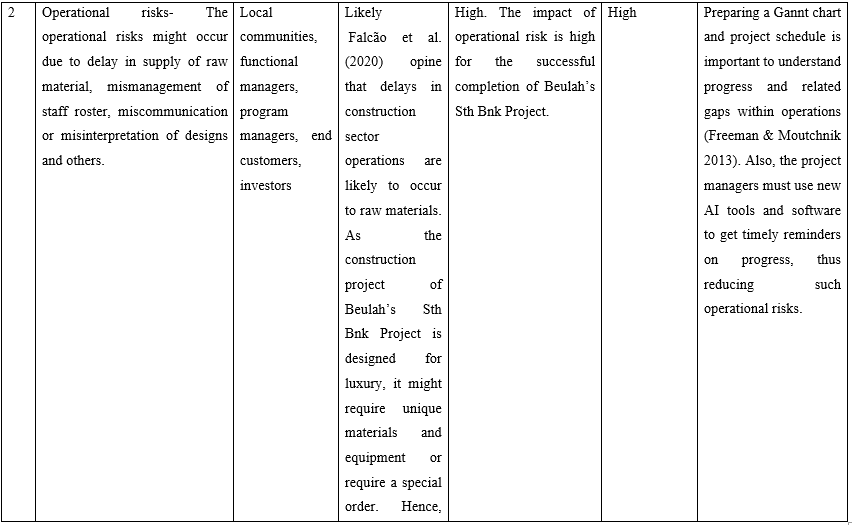

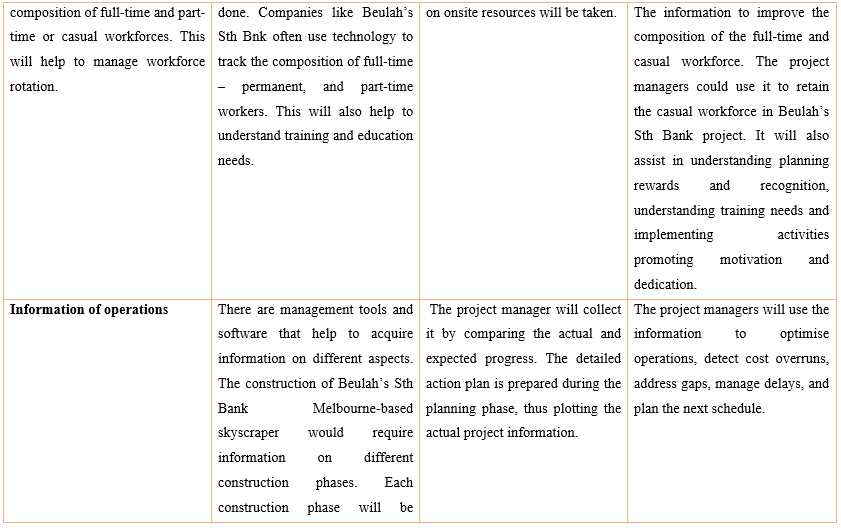

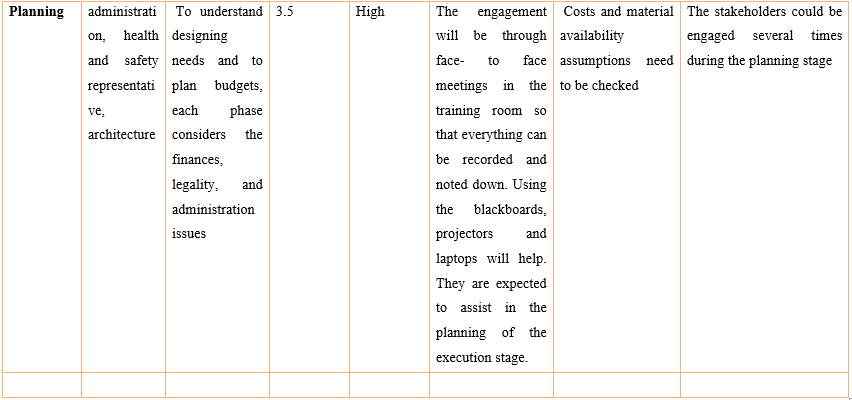

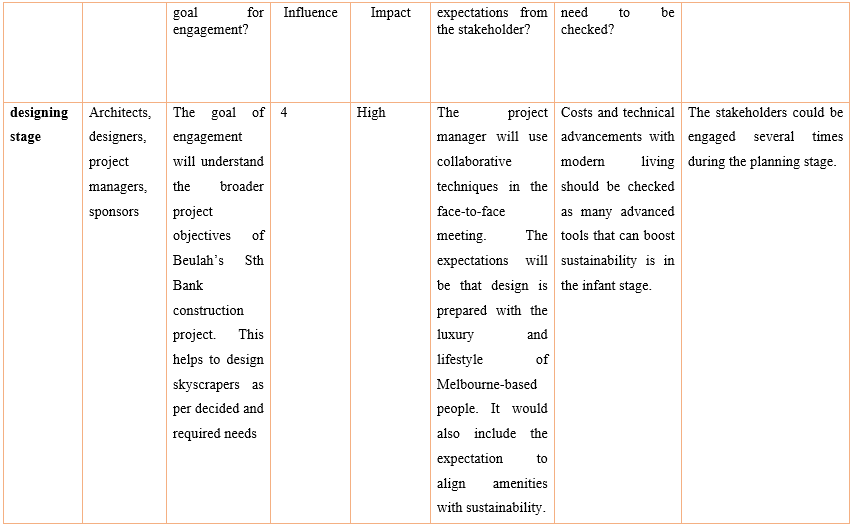

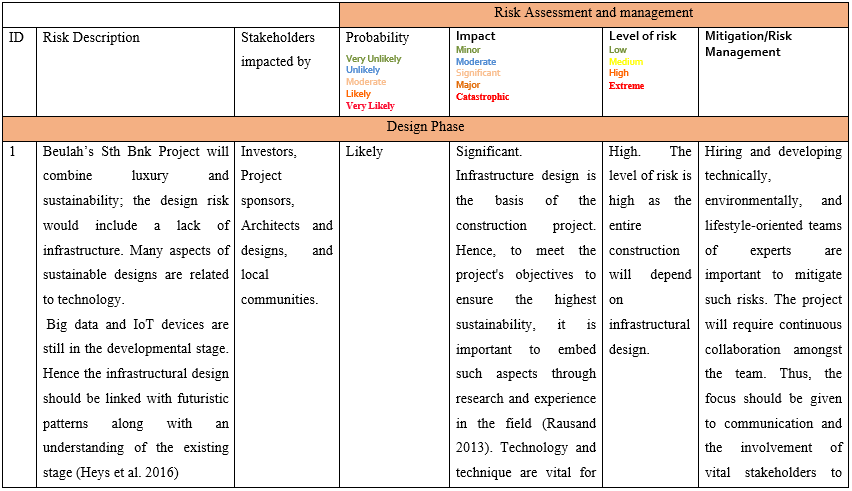

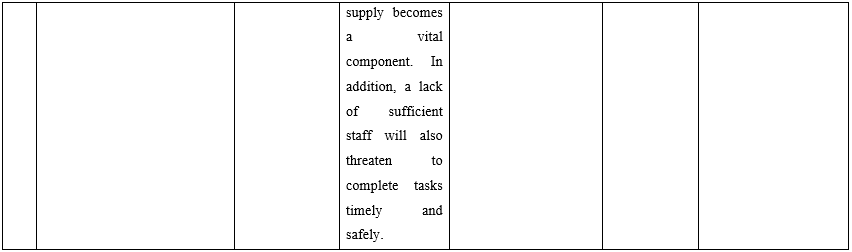

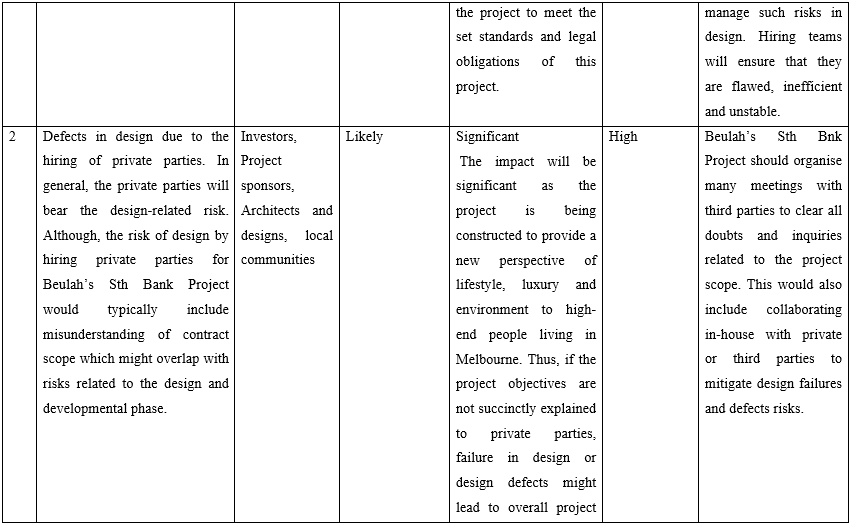

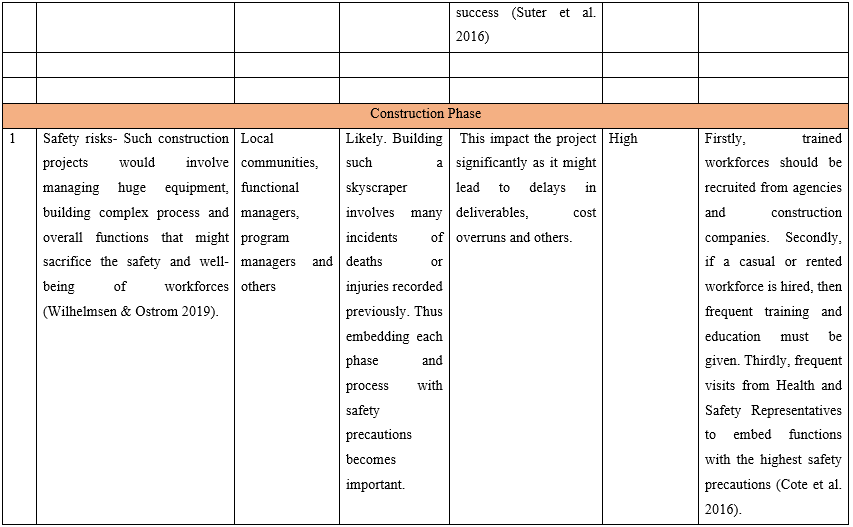

Risk Assessment and Analysis

Stakeholder Management Plan

List of Key stakeholders:

Stakeholders are individuals, groups and organisations whose existence impacts the organisation. Stakeholders might be actively involved and work hard to make the project successful. In addition, stakeholder groups will also include groups or agencies like governments, investors, and sponsors. Thus, they might be internal or external (Eskerod & Huemann 2013).

For the project, Beulah’s Sth Bnk, which is a luxury and sustainable real estate project, the list of stakeholders would include

• Architecture and designers
• Technological and environmental experts
• Project sponsors and investors
• Program managers
• Contractors and subcontractors
• Project-related employees and suppliers
• Government authorities
• Suppliers
• Labour unions
• End – customers

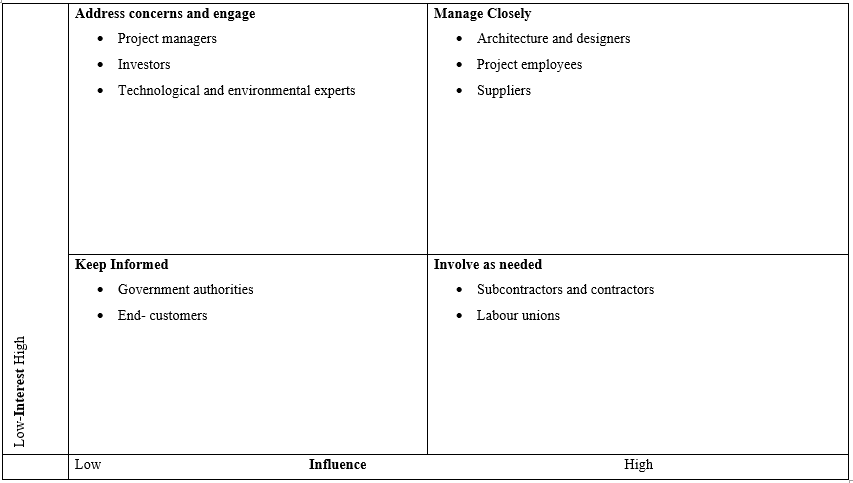

Create a Matrix based on Power and influence grid:

Who are we engaging, and how do we reach them?

External stakeholders:  This stakeholder group would include governments, suppliers, technological and environment experts, labour unions, contractors and others

Community:

Internal stakeholders:

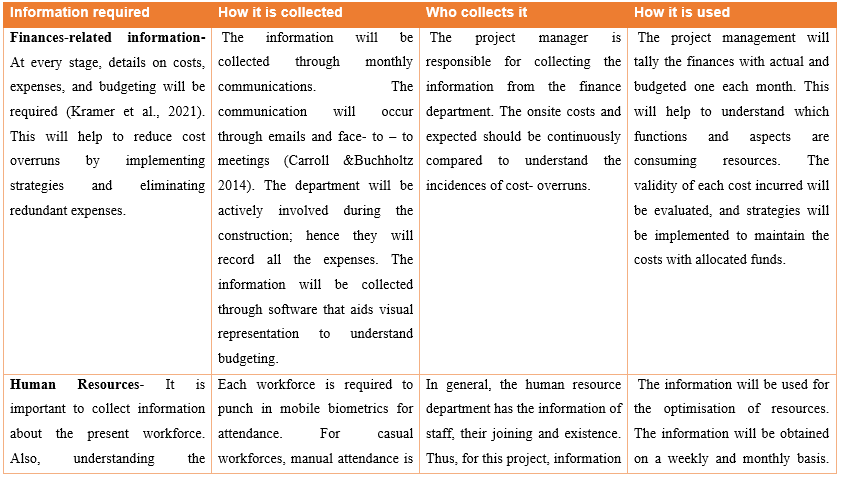

How do we collect input/feedback?

Plan:

Conclusion

Beulah’s Sth Bnk is a construction project for which a risk assessment and stakeholder management plan have been prepared. The project will face two major risks: design and construction (operational and safety related). Also, different groups will be managed based on the matrix explained.

References

Aven, T. 2016 ‘Risk assessment and risk management: Review of recent advances on their foundation, European Journal of Operational Research, vol. 253, no. 1, pp.1-13.

Beach, S, Keast, R and Pickernell, D 2012, ‘Unpacking the connections between network and stakeholder management and their application to road infrastructure networks in Queensland, Public Management Review, vol. 14, no. 5, pp.609-629.

Carroll, AB and Buchholtz, AK 2014, ‘Business and society: Ethics, sustainability, and stakeholder management, Cengage Learning.

Cote, I, Andersen, ME, Ankley, GT, Barone, S, Birnbaum, LS, Boekelheide, K, Bois, FY, Burgoon, LD, Chiu, WA, Crawford-Brown, D and Crofton, KM 2016, ‘The Next Generation of Risk Assessment multi-year study—highlights of findings, applications to risk assessment, and future directions, Environmental health perspectives, vol. 124, no.11, pp.1671-1682.

Dekkers, S, Oomen, AG, Bleeker, EA, Vandebriel, RJ, Micheletti, C, Cabellos, J, Janer, G, Fuentes, N, Vázquez-Campos, S, Borges, T and Silva, MJ 2016, ‘Towards a nonspecific approach for risk assessment’, Regulatory Toxicology and Pharmacology, vol. 80, pp.46-59.

Eskerod, P and Huemann, M 2013, Sustainable development and project stakeholder management: What standards say. International Journal of Managing Projects in Business.
Falcão, P, Ramalho, N and Nobre, M 2020, ‘Stakeholder management: the new role of business diplomacy’,. Journal of Business Strategy.

Freeman, E and Moutchnik, A 2013, ‘Stakeholder management and CSR: questions and answers, .uwf UmweltWirtschaftsForum, vol. 21, no. 1, pp.5-9.

Heys, KA, Shore, RF, Pereira, MG, Jones, KC and Martin, FL 2016, ‘Risk assessment of environmental mixture effects’, RSC advances, vol. 6, no. 53, pp.47844-47857.

Kramer, MP, Bitsch, L and Hanf, JH 2021, ‘The impact of instrumental stakeholder management on blockchain technology adoption behavior in agri-food supply chains,  Journal of Risk and Financial Management, vol. 14, no. 12, p.598.

Mok, KY, Shen, GQ and Yang, J 2015, ‘Stakeholder management studies in mega construction projects: A review and future directions,’ International journal of project management, vol. 33, no. 2, pp.446-457.

Rauland, M 2013, ‘Risk assessment: theory, methods, and applications (Vol. 115)’ John Wiley & Sons.
Suter II, GW 2016, ‘Ecological risk assessment,’ CRC press.

Wilhelmsen, CA and Ostrom, LT 2019, ‘Risk assessment: tools, techniques, and their applications, John Wiley & Sons.

Zbuchea, A and Monica, BIRA 2020,  ‘Does stakeholder management contribute to a museum’s sustainable development?’ Management Dynamics in the Knowledge Economy, vol. 8, no. 1, pp.95-107.

Still in Dilemma? See what our users have to say about our services.

student rating
Management

Essay: 10 Pages, Deadline: 2 days

They delivered my assignment early. They also respond promptly. This is excellent. Tutors answer my questions professionally and courteously. Good job. Thanks!

flag User ID: 9***95 United States

student rating
Accounting

Report: 10 Pages, Deadline: 4 days

After sleeping for only a few hours a day for the entire week, I was very weary and lacked the motivation to write anything or think about any suggestions for the writer to include in the paper. I am glad I chose your service and was pleasantly pleased by the quality. The paper is complete and ready for submission to the professor. Thanks!

flag User ID: 9***85 United States

student rating
Finance

Assignment: 8 Pages, Deadline: 3 days

I resorted to the MBA assignment Expert in the hopes that they would provide different outcomes after receiving unsatisfactory results from other assignment writing organizations, and they genuinely are fantastic! I received exactly what I was looking for from this writing service. I'm grateful.

flag User ID: 9***55

student rating
HR Rrecruiter

Assignment: 13 Pages, Deadline: 3 days

Incredible response! I could not believe I had received the completed assignment so far ahead of the deadline. Their expert team of writers effortlessly provided me with high-quality content. I only received an A because of their assistance. Thank you very much!

flag User ID: 6***15 United States

student rating
Management

Essay: 8 Pages, Deadline: 3 days

This expert work was very nice and clean.expert did the included more words which was very kind of them.Thank you for the service.

flag User ID: 9***95 United States

student rating
Thesis

Report: 15 Pages, Deadline: 5 days

Cheers on the excellent work, which involved asking questions to clarify anything they were unclear about and ensuring that any necessary adjustments were made promptly.

flag User ID: 9***95 United States

student rating
Economics

Essay: 9 Pages, Deadline: 5 days

To be really honest, I can't bear writing essays or coursework. I'm fortunate to work with a writer who has always produced flawless work. What a wonderful and accessible service. Satisfied!

flag User ID: 9***95

student rating
Taxation

Essay: 12 Pages, Deadline: 4 days

My essay submission to the university has never been so simple. As soon as I discovered this assignment helpline, however, everything improved. They offer assistance with all forms of academic assignments. The finest aspect is that there is also an option for escalation. We will get a solution on time.

flag User ID: 9***95 United States

student rating
Management

Essay: 15 Pages, Deadline: 3 days

This is my first experience with expert MBA assignment expert. They provide me with excellent service and complete my project within 48 hours before the deadline; I will attempt them again in the future.

flag User ID: 9***95 United States

GET A FREE ASSISTANCE

Still Finding MBA Assignment Help? You’ve Come To The Right Place!
